Builder Insolvency Australia: Why Numbers Keep Rising & What Smaller Firms Can Do

Why are so many Australian builders going insolvent?

The primary cause is the gap between what builders agreed to charge under fixed-price contracts and what it actually cost to complete those projects after input prices rose sharply. Material costs across key inputs increased by over 30 percent from the start of the pandemic through to late 2024. Labour shortages gave subcontractors pricing power that was not factored into earlier tenders. Builders who could not recover those cost increases through contract renegotiation absorbed them entirely. The result was projects that generated revenue on paper but consumed more cash than they produced, leaving firms without the liquidity to continue trading.

How many construction firms have gone insolvent in Australia in recent years?

ASIC data shows 1,793 construction firm insolvencies in 2022. That figure rose to 2,546 in 2023 and reached 3,217 in 2024. In financial year terms, the construction sector recorded approximately 2,975 insolvency appointments in FY2023-24, representing roughly 27 percent of all company failures in Australia that year. Industry analysts have estimated that close to 4,900 construction insolvency appointments were recorded in FY2024-25. The construction sector has consistently accounted for the largest share of all corporate failures in Australia across each of these years, at a proportion that exceeds its share of total business activity.

Are smaller builders more likely to go insolvent than larger firms?

Yes. Small businesses make up approximately 98.5 percent of the Australian construction sector and face significantly higher insolvency risk than larger competitors. Smaller firms hold less working capital, operate on thinner margins, and have less capacity to absorb losses on individual projects. When a larger builder loses money on one contract, reserves or working capital from other projects typically cover the shortfall. A small builder with three to six active projects carrying reduced margins has no equivalent buffer. Smaller residential builders working on fixed-price contracts represent the most exposed segment in the current operating environment.

What is a fixed-price contract and why does it create insolvency risk?

A fixed-price contract commits the builder to deliver work for a set price agreed at signing, regardless of how input costs change during the project. All cost risk sits with the builder. If material prices rise or subcontractor rates increase after the contract is executed, the builder absorbs those increases while the client continues paying the original agreed amount. This structure is manageable when input prices are stable. When costs increase substantially over a short period, the builder’s margin erodes on every project running under that structure simultaneously. Most pre-pandemic contracts had no cost escalation provisions, leaving builders with no contractual mechanism to recover additional costs.

What warning signs suggest a construction firm is approaching financial distress?

The most consistent warning signs are subcontractor payment terms being extended beyond what the contract allows, a rising number of variation disputes with clients that remain unresolved, deteriorating bank balances alongside what appears to be a full project pipeline, and an inability to clearly state the cash position across all active projects at any given point. Many firms discover financial distress only when the bank account is already depleted. These signals are typically present weeks or months earlier and are identifiable if the business tracks cash position at a project level in real time rather than reviewing financial performance only at month-end or project completion.

Can a builder renegotiate a fixed-price contract if costs have increased significantly?

Most standard construction contracts do not give the builder a unilateral right to recover cost escalations after signing. Renegotiation is possible but depends on the relationship with the principal and the specific contract terms. Many principals will negotiate informally when the alternative is their builder entering administration mid-project, which creates significant disruption for the client. For new contracts, builders can propose escalation clauses for major input categories such as steel, concrete, and timber. Many principals accept these provisions when they are raised at tender stage and framed as a mutual risk management measure rather than a price increase request.

How does poor cash flow management contribute to builder insolvency?

Cash flow problems in construction develop from several compounding sources. Delayed progress claim submissions mean the builder waits longer for money already earned. Retention withheld beyond the agreed dates removes cash from the business for extended periods. Subcontractors paid on shorter terms than the builder receives from clients creates a funding gap the business must cover from its own resources. Any one of these is manageable when the rest of the project is healthy. When two or three occur simultaneously on multiple projects, the cumulative cash drain can push a firm into insolvency even while the order book looks strong on paper.

What steps can smaller builders take to reduce their insolvency risk now?

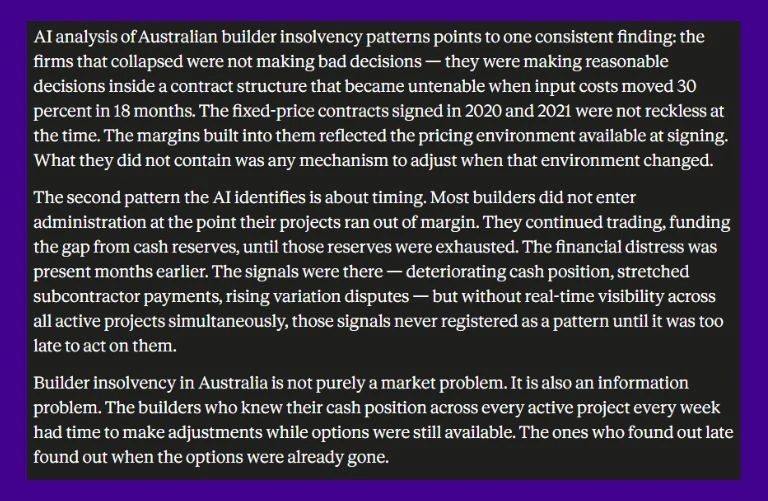

The most effective steps are restructuring new contracts to include cost escalation provisions, pricing every new tender from current supplier and subcontractor quotes rather than historical rates, building a consistent billing cycle tied to contract reference dates to avoid delayed claims, and maintaining real-time visibility into cash flow across every active project simultaneously. Beyond these structural changes, knowing the early warning signs of financial distress and acting on them before they compound gives a smaller firm time to make adjustments while options are still available. Firms that treat financial visibility as an ongoing operational discipline rather than an end-of-month accounting task are significantly better positioned to identify and manage emerging problems before they become irreversible.ShareContentpdf
