Progress Claim Construction Australia: How to Write One That Holds Up

A Perth subcontractor finishes six weeks of concrete formwork on a mid-rise residential build. The job is done. The quality sign-off has been completed. He sends an invoice to the head contractor and considers the matter settled. Three weeks pass. Nothing comes through. When he calls, the head contractor informs him the invoice was not a valid payment claim under Western Australia’s security of payment legislation. No valid claim means no obligation to issue a payment schedule. No payment schedule means no right to adjudication. He has no legal path under the Act. His only remaining option is a standard debt recovery action through the courts, which will take months and cost him money he does not have. The work was done correctly. The amount was not in dispute. But a progress claim construction Australia contractors depend on for cash flow is not simply an invoice. It is a legal document governed by state legislation, and one missing element is enough to strip every protection the Act was built to provide.
What the Law Actually Requires in a Progress Claim Construction Australia?
The work must be identified clearly.
A claim must specify the construction work or goods and services it covers. “Works completed to date, AUD 38,500” does not meet this standard. An adjudicator needs to link each claimed item to actual work completed. When a claim clearly states what was done, when it was done, and which contract item it relates to, it becomes difficult to challenge.
The claimed amount must be presented without ambiguity.
Many contractors end up writing the claims that bring together the current billing period, retention withheld, and amount previously unpaid and variation claims, in all under one total figure. This ends up creating problems at adjudication. Each of these elements are supposed to be noted separately so the respondent and any adjudicator can easily assess it and know what is being claimed and what is not.
The legislative endorsement statement must appear where required.
There are many states, like Victoria, South Australia, and Western Australia, that still require mandatory endorsement, but many other states have not made it mandatory, like New South Wales. Where there is a need of mandatory endorsement, a Progress Claim Construction Australia must state that it is made under the relevant security of payment act. Any payment claims served in those states without the endorsement is invalid from the moment it leaves the contractor’s hand.
Queensland head contractors carry an additional obligation.
In Queensland, a supporting statement attesting to subcontractors’ payment for the pertinent period must be included with each payment claim made by a head contractor. If any are still owing, the statement must list them, specify how much is still owed, and provide an explanation for the payment withholding. Even inadvertently omitting this declaration raises a procedural problem that the reply could exploit to refute the Progress Claim Construction Australia.
Reference Dates and Time Limits That Catch Experienced Contractors
One of the most commonly misunderstood elements of the Progress Claim Construction Australia process is reference date. Even the contractors with every document ready and prepared can miss this one thing. A reference date is the point in time from which a contractor becomes legally entitled to serve a payment claim. It also states what work can be included. Any work performance that is covered in claim after this particular reference date is automatically invalid.
Most contracts define reference dates clearly. They may fall on the last day of the month, on milestone completion dates, or on another schedule set for the project. If the contract does not specify them, the legislation usually applies a default monthly reference date.
In Queensland, the concept of the reference date was removed from the legislation in 2017. The state now operates on a monthly payment entitlement framework that does not require contractors to identify a reference date in the same way. Contractors working across multiple states need to understand which rules apply where.
The time limits for serving a Progress Claim Construction Australia after completing work vary considerably between states:
- New South Wales and the ACT: 12 months from the date the work was last carried out
- Queensland and South Australia: six months from last carrying out work or supplying goods or services
- Victoria: three months from last carrying out work
- Western Australia: 12 months from last carrying out work
Missing these windows can cause you the removal of the right to use the Act entirely for that body of work. Then a contractor can only pursue the amount with the help of ordinary contract law, which is way slower and more expensive, and it contains no protections that the Act provides. There is this one additional restriction that is applied in New South Wales. A claimant can serve only one payment claim per reference date.
Serving the Progress Claim Construction Australia in a Way That Is Legally Recognised
There is a way of writing a valid payment claim, which is a single step, but the other step is delivery, to deliver it in a way that the law recognizes it. A claim should be perfectly drafted, but it cannot be incorrectly served, as though it was never even submitted. Service requirements are defined by a combination of the contract and the applicable legislation. Personal delivery is the perfect way to satisfy both. This personal delivery should be to the address of the respondent or their authorized representative. The delivery should be a registered post to the respondent’s last known business address or delivering the document at the respondent’s principal place of business.
Email is not automatically valid.
It is common to think that email can be the most appropriate way to communicate for payment claims, but this assumption is very wrong unless the contract specifically permits electronic services or there is a consent from a respondent to receive documents in that way. If there is no consent or contract permit regarding the email, a respondent can win the argument. The claim is treated as unserved regardless of whether they received and read it.
The time of service affects the respondent’s deadline.
A payment claim should not be delivered after the standard business hours because most courts and adjudicators treat it as served on the unacceptable business days. If a claim is delivered at 8 p.m. on the 31st of a month, it does not give respondent enough time or deadline to calculate from that evening.
The Documentation That Makes a Claim Hard to Challenge
A valid progress claim may trigger the legal process, but the documentation behind it decides whether the claim amount will survive if the respondent disputes it. It is common knowledge that a respondent serves a payment schedule for less than the claimed amount. The claimant applies for adjudication. The adjudicator is going to review both sides. They do not take assertions on faith. They demand concrete proof that connects the claimed amount to the verified work.
Before submitting a progress claim, the following should already be assembled and filed:
- Daily site records or progress reports covering each day of the billing period, noting activities completed, workers and subcontractors present, delays experienced, and any instructions received from the superintendent or site manager.
- Written variation instructions for every out-of-scope item included in the claim. Verbal instructions are almost impossible to substantiate at adjudication. A follow-up email confirming the instruction is the minimum standard.
- Delivery dockets and goods received records for any materials claimed. These should match the purchase order and the quantities included in the claim.
- Progress photographs with embedded timestamps and location data confirming the state of the work at the time of the claim.
- A claim schedule setting out the contract sum, previous claims, previous payments, and the current claimed amount in a clear table that any reviewer can follow without additional explanation.
What can help you keep a record?
There is many construction management software out there, like Onsite, that helps you record daily progress reports, capture geotagged site photos, and track subcontractor work orders and milestone billing in one place. It gives a contractor a clear, visible view of everything that is taking place in a construction project. If a record is being kept from day one, the claim preparation becomes way stronger. Every contractor who keeps on building this habit of consistently keeping documents, never has to face problems.

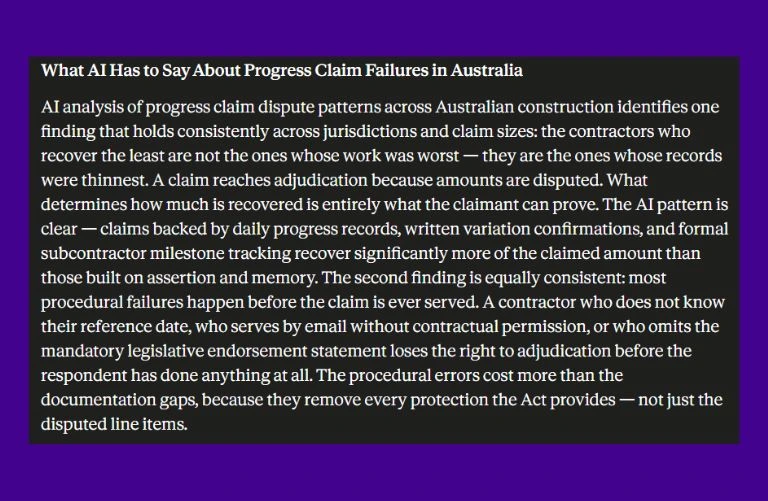

What Happens After You Submit and What to Watch For?
Serving a valid progress claim transfers specific legal obligations to the respondent. Understanding these legal obligations can work in the favor of contractors to manage the post-submission period without losing any right. Respondents can take a few actions, either they pay the full claimed amount by the due date, or they serve a payment schedule within the required time frame in which they explain how much they are willing to pay and why they’re withholding a particular amount.
The payment schedule timeframes by state are as follows:
- New South Wales: ten business days from the date the payment claim was received
- Victoria: ten business days from the date the payment claim was received
- Queensland: fifteen business days from the date the payment claim was received, or the period specified in the contract if shorter
The withheld amount by the respondent should be explained in detail about each deduction. Just by stating a lower amount without reason cannot make it valid. In most of the cases, respondents cannot later raise arguments in adjudication that were not included in the original schedule.
If there is no payment schedule being issued in the required time frame, the claimant has the right to enforce the full claimed amount as a judgment debt without going through adjudication. This particular case is only possible if the original payment claim was procedurally valid.
When a payment schedule disputes part of the claim, timing becomes critical. In New South Wales and Victoria, adjudication applications generally must be filed within ten business days of receiving the schedule. In Queensland, the period is thirty business days. These deadlines should be tracked immediately, not after deciding whether to proceed.
Treating Every Claim as the Legal Document It Is
Contractors that are losing money on their valid work are not facing disputes over quality, but the real issue is the procedural mistake they make in the claim itself. That particular mistake can be used against them by the respondent. It is not very hard work to make a progress claim under Australian construction law. The required elements are clear, the deadlines are defined, the service rules can be understood without legal training, but the real big thing is treating the process seriously instead of just rushing it at the end of the billing cycle.
Contractors that receive regular compensation typically use the same strategy. On the first day of the billing cycle, they start preparing the claim. Every day, site records are updated. When variation instructions are given, they are verified in writing. As part of standard site procedure, progress images are saved with timestamps.
The supporting documentation is ready by the time the reference date comes around. The evidence makes it more difficult for the responder to defend withholding payment, and the claim becomes simpler to draft.
It is not a complex system. It is a matter of discipline, and in Australian construction, that discipline often determines whether a claim succeeds or fails.
FAQs
A progress claim is a formal request for payment made by a contractor, subcontractor, or supplier under a construction contract. It covers work completed or goods and services supplied during a defined billing period. Under Australia’s security of payment legislation, a valid progress claim triggers specific legal obligations on the respondent, including the requirement to either pay the claimed amount or issue a payment schedule within a strict deadline. A progress claim is a legal document, not just a project invoice. When prepared and served correctly, it gives the claimant enforceable rights including adjudication and court judgment debt recovery.
A valid progress claim must clearly identify the construction work or goods and services it covers, state the amount being claimed, and in most states include a statement that the claim is made under the relevant security of payment legislation. Head contractors in Queensland must also include a supporting statement about subcontractor payment status. The claim must be served on or after the applicable reference date and within the time limit set by the legislation in the state where the work was performed. A claim missing any of these elements may be invalid, which removes the claimant’s right to use the adjudication process for that billing period.
A reference date is the date from which a contractor becomes entitled to serve a payment claim. It is typically set by the construction contract, often falling on the last day of each calendar month or on project milestone dates. A payment claim served before the reference date falls due is invalid. The reference date also limits what work can be included — generally only work completed on or before that date qualifies. When the contract does not specify reference dates, the relevant state legislation provides a default. Contractors who are unclear on their reference dates risk serving claims too early, too late, or for the wrong period of work.
The correct method of service depends on what the construction contract requires and what the relevant state legislation permits as a default. Standard acceptable methods include personal delivery, registered post to the respondent’s principal place of business, or leaving the document at that address during business hours. Email is only valid where the contract expressly allows electronic service or the respondent has confirmed in writing that they accept documents by email. Delivering a claim through an unaccepted method can mean it is treated as never served, even if the respondent received and read it. Always check the contract’s notice clause before choosing a delivery method.
When a respondent receives a valid payment claim and fails to issue a payment schedule within the required timeframe, they become liable for the full claimed amount. In New South Wales and Victoria, the payment schedule must arrive within ten business days. In Queensland, the limit is fifteen business days. A claimant in this situation can apply to have the amount enforced as a court judgment debt without going through adjudication. This enforcement pathway is one of the strongest protections the Act provides, but it requires the original payment claim to have been procedurally valid. A defective claim removes the respondent’s obligation to respond.
