Construction Daily Report: What Australian Site Supervisors Must Record to Protect the Project

What is a construction daily report and why is it important?

A construction daily report is a contemporaneous record of site conditions, work completed, resources deployed, instructions received, and any events that affected the project on a given day. In Australian construction, it is one of the most important documents a project produces because it is the primary evidence base for delay claims, extension of time applications, progress claim support, and variation disputes. A daily report written on the day it covers is treated as a contemporaneous record by courts and adjudicators. A report compiled from memory days or weeks later is treated as a reconstruction and carries significantly less evidential weight. The daily report is useful as an operations tool and essential as a legal one.

What information must a construction daily report contain in Australia?

A complete construction daily report should record the date and project details, weather conditions and their impact on site activities, the number and trade category of workers present, which subcontractors were on site and what they were working on, work activities completed with measurable quantities, plant and equipment deployed and for what purpose, any instructions received from the superintendent or client representative with the name of the person who gave them, delays or disruptions with their causes and duration, visitors to the site, and any safety incidents or WHS observations. Each of these categories serves a specific legal or commercial purpose if the project enters a dispute. Leaving any of them out consistently creates an evidential gap that can weaken a claim or strengthen an opposing one.

How does a construction daily report support a progress claim under the Security of Payment Act?

Under Australia’s Security of Payment Act, a progress claim must be supported by documentation demonstrating that the claimed work was actually completed. When a respondent issues a payment schedule for less than the claimed amount and disputes specific quantities, the daily reports from the billing period are the primary evidence submitted to an adjudicator. A daily report series that records specific activities, measurable quantities, and the subcontractors who carried out the work provides an evidential basis for the claimed amounts. One that is vague, incomplete, or absent for some days in the billing period is difficult to use even when the work was genuinely completed. Adjudicators consistently note that documentation quality affects how much of a disputed claim can be awarded.

Why do verbal instructions need to be recorded in the daily report on the same day?

A verbal instruction from a superintendent or project manager that is not recorded on the day it is given has no contemporaneous record to support it. If the instruction later becomes the basis for a variation claim or an extension of time application, the contractor’s evidence is their memory of an event that the other party may dispute or deny. Recording the instruction in the daily report on the day it was given creates a contemporaneous record: the name of the person who gave the instruction, what it covered, and the date and time it was received. This record cannot be challenged on the grounds of faulty memory or post-dispute reconstruction because it was created before any dispute existed.

What makes a daily report legally defensible in a construction dispute?

The characteristics that make a daily report legally defensible are contemporaneous creation on the day it covers, specificity in describing activities, quantities, subcontractors, instructions, and delays, consistency in format and level of detail across every day in the project record, and accompanying photographs with embedded timestamps. A report that meets these standards is difficult to challenge because it was not created in response to a dispute and does not exhibit the characteristics of selective record-keeping. A report that was clearly completed later, that has unusually detailed entries for the disputed period surrounded by vague ones, or that lacks photographs to support its written descriptions is easier to discount in adjudication or arbitration.

Can a daily report with gaps be used in a construction dispute?

A daily report series with unexplained gaps is usable but weakened. The opposing party will ask what happened on the days without records. The absence of a record does not confirm that nothing significant occurred. It suggests that records were not kept consistently, which raises questions about the reliability of the days that were recorded. If the gaps happen to cover the days most relevant to the dispute, the credibility problem is compounded. A contractor whose record series has gaps in the contested period but detailed records immediately before and after it will face questions about why those specific days were not recorded. Consistent daily record-keeping eliminates this vulnerability entirely.

How should weather be recorded in a construction daily report to support a delay claim?

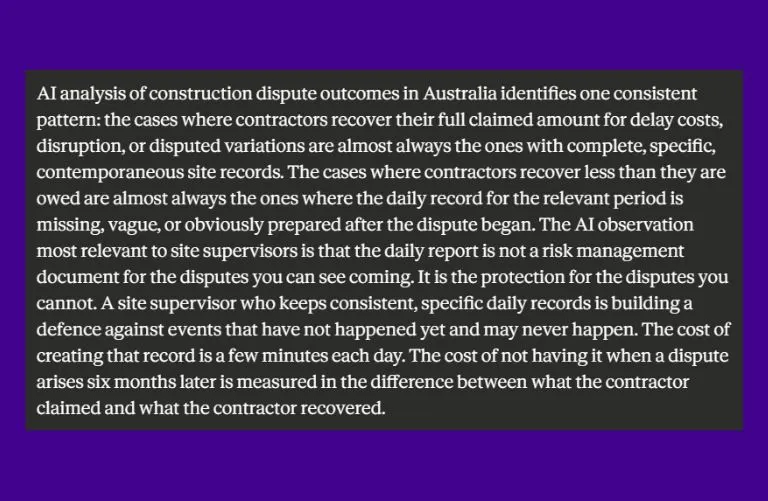

A weather record in a daily report that is useful for a delay claim must state the specific conditions, not just a general description. Recording “poor weather” does not tell an adjudicator what the conditions were, whether they prevented specific activities, or how the contractor responded. A useful weather record states the conditions observed, such as heavy rainfall commencing at 7am, which activities could not proceed as a result, when normal work resumed, and what was done in the interim. This level of specificity connects the weather event to the programme impact, which is the connection an adjudicator needs to assess an extension of time claim. A vague weather record can show that the day was acknowledged as difficult. It cannot demonstrate that a compensable delay event occurred.
