Construction Cost Overruns Australia: Three Places Contractors Lose Money Before They Notice

A contractor in Queensland closes a commercial fit-out in March. All went really well in four months of work, and he made good relationships with clients as well. When the handover was done in March, he opened final cost reconciliation in April. His margin should have been seven percent, but he found out that it was only 1.2 percent. So, like anyone he went through the history of the project to find out the gap but found none. There was no supplier who overcharged or no variation that was flagged. However, the margin was taken away across three separate categories over the period of these four months but none of it was visible in the data of the weekly report. Each data was visible but only in hindsight, and only after it was too late to do anything about it. This is the pattern behind construction cost overruns Australia contractors face most often. It is never one huge blow but slow invisible drains.
How Widespread Construction Cost Overruns in Australia is?
The frequency of construction cost overruns Australia is not an industry secret. There have been multiple bodies that measured it and the numbers are unflattering.
Research from the Grattan Institute puts the share of Australian infrastructure projects that run over budget at around 65 percent. The overrun magnitude, measured after principal contracts have been awarded, typically falls between nine and 20 percent of the original approved cost. A separate KPMG survey of construction firms found that across a three-year period, fewer than one in three Australian construction projects finished within ten percent of the budget they started with.
A government-commissioned review completed in late 2023 examined 82 publicly owned infrastructure projects with a combined value of AUD 120 billion. Roughly AUD 33 billion of that portfolio had overrun its approved cost. That is a substantial proportion of public capital spending failing to land within the figures that were used to approve it.
In the residential sector, an ABS study of new home construction across the five years to June 2024 found consistent patterns of budget overrun and schedule extension. The projects most affected were those priced and designed in 2020 and 2021 that ran into the cost environment of 2022 and 2023 during construction. The budget assumptions and the building conditions no longer matched.
One further detail from the Grattan research is worth noting. A small share of cost categories generates a disproportionately large share of the total overrun value. The majority of the financial damage concentrates in a small number of line items which means targeted attention on the highest-risk cost categories delivers more protection than general budget vigilance across all items equally.
What the Numbers Say?
The Grattan Institute puts the proportion of Australian infrastructure projects that run over budget at around 65 percent, with a typical overrun of nine to 20 percent after contracts are awarded. KPMG survey data shows fewer than one in three Australian construction projects completing within ten percent of their original budget across a recent three-year period. A government review of 82 publicly owned infrastructure projects worth AUD 120 billion found approximately AUD 33 billion in cost overruns across the portfolio. Scope growth tends to compound cost exposure, research tracking project scope behaviour shows that uncontrolled scope expansion consistently produces a cost overrun that runs ahead of the scope increase itself. These figures are drawn from formal, government-tracked projects. Overrun rates on smaller private residential and commercial builds are not systematically published but are widely understood among practitioners to be at least as high.
Sources: Grattan Institute, KPMG Construction Survey 2019, Australian Government Infrastructure Project Review November 2023, iseekplant citing Grattan research

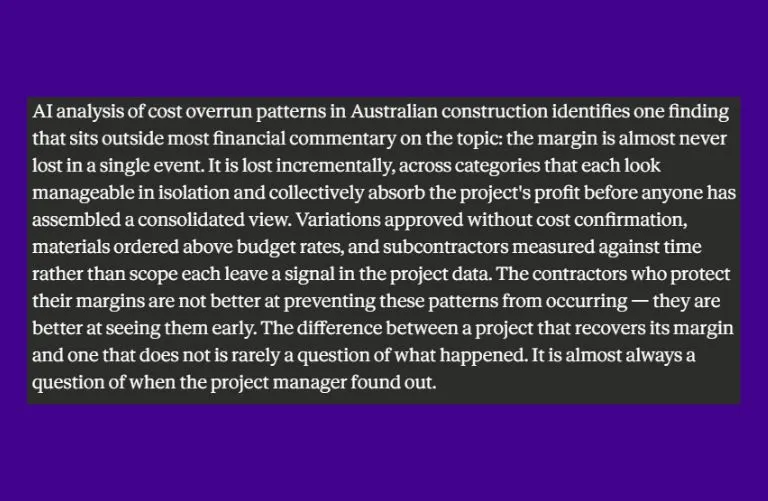

What AI Has to Say About Construction Cost Overruns in Australia?

Place One: Variations Approved Before Anyone Has Costed Them
The very first place that can cost a contractor money without any realisation is the variation process. Variation is supposed to happen in construction projects and is unavoidable but it is not the real issue. The issue is delivery of information, the cost of it, and visibility.
On any normal Australian construction site, the variations are delivered verbally. A site superintendent asks the supervisor to do changes like making a doorway and he gets it done.
However, the formal variation is raised after a week or a month. Till then the work is done but the project cost has increased.
Two patterns make this worse:
- The variation is approved in scope but not in cost – A superintendent might have approved the variation that seemed too simple without any cost discussion because the variation looked small to him. However, it left the contractor exposed to the full difference between what the work actually cost and what the client agrees to pay when the formal order is raised.
- Individual variations look manageable but collectively exceed the contingency – When each variation is reviewed in isolation, nothing seems problematic. Twenty variations, each at AUD 4,000 to 8,000, do not individually trigger concern. Aggregated, they may represent AUD 120,000 in unbudgeted cost against a contingency of AUD 80,000, a shortfall that is invisible until someone adds them all up.
According to research, project scope frequently increases by 15% over the initial contract. Cost pressure increases more quickly than many teams recognize as a result of these developments.
The answer is simple. Before work starts, each variant should be priced, and both the scope and the cost should be approved by the client. Instead of being kept in a separate register that is only evaluated at closeout, the total amount of permitted changes should be maintained throughout the project alongside the original contract budget.
Place Two: Materials Ordered at Rates the Budget Never Accounted For
Procurement is the top second place where contractors lose money. Surprises come when you see the gap between the material budget and what was actually paid. Initially when the budget is made, the supplier quotes are used but they only remain accurate at the moment they were issued. Weeks or months later, the procurement process is taking place from current pricing and current availability.
This gap is present at the majority of the projects. The question is how to track it.
Several patterns cause it to widen without being noticed:
- Orders placed without reference to the budget line – Mostly, it is about ignorance. If a contractor is not cross-checking the rate of the material the supplier charges against the budget, the gap is going to be accumulating.
- Price changes accepted verbally and not recorded – Later, when the supplier announces that the prices of material have increased, the supervisor just agrees to that price because the project cannot be delayed and the task cannot be shifted. But there is no formal return record of it. The project budget hence was never updated.
- Multiple small top-up orders that individually seem minor – There’s always something extra to order, be it concrete or some extra fittings. These orders may seem very small to be approved without any scrutiny, but collectively they become a huge price that calls harm to the budget.
The stage of procurement is one of the highest leverage points for protecting construction project margins. This is the reason why it becomes necessary to attach every purchase order to the budget so that you can see the material cost against the committed budget towards the project. When the budget is not linked to the procurement process, it often leads to overrun that is often discovered by the end of the month when everything cannot be undone.
Place Three: Subcontractor Costs Measured Against Time Instead of Scope
Subcontractor is also one of the biggest parts of construction and where the project loses money. The majority of the construction business is measuring the cost of subcontractors against time. Instead of measuring the work against time, we need to ask questions like, how much have we spent? And does it match how much of the work has been done at a site? The answer to these questions gives more clarity. A subcontractor working on a commercial concrete structure built for three weeks agrees at a weekly rate. This may look normal because it is simple, three weeks of billing for three weeks of work. However, if you look at the situation from a different perspective, the perspective of a scope based system, the questions will be raised like how much of structure was completed in three weeks against quantity in the work order. It can create chaos if a subcontractor has consumed 60% of the material but has only done the 40% of the work. This problem only arises after the monthly report gets out.
Three things are required to track subcontractor performance against scope properly:
- A work order that defines the contracted scope in specific, measurable quantities rather than a general description
- A completion record updated at regular intervals showing actual progress against those quantities
- A cost-to-complete figure calculated from actual progress, not from elapsed time or invoices received
What Contractors Can Do to See Overruns Before They Set?
Construction cost overruns Australia contractors face are not primarily caused by events that cannot be anticipated. They are caused by information that arrives too late to act on.
The three categories that are mentioned above create their own individual warning signals. These signals should be visible to a contractor in real-time, rather than finding it by the end of the month.
On variations: Any variation introduced in a construction project should be addressed immediately. It should be introduced formally rather than just putting it out there verbally. The variation should be communicated immediately, not weeks later at the next review meeting. A project manager cannot know variation when he is halfway through the project and 75% of the task has already been done. This asks for rework and uses extra material and takes more time than anticipated.
On procurement: It is necessary to link every purchase order to the budget line before approval. It gives visibility to project managers to see committed spending against each budget category. It provides a clear picture of what has been ordered, what has been received, and what budget remains available. This saves time from making extra reports, as well as it gives more control over the project.
On subcontractor tracking: A week-end or two week-end progress review against work order quantities can be enough to track the cost of subcontractor and the completion of the task. Once the cost and progress begin to diverge, the project manager can easily look at the issue earlier than it was before.
There are construction management software for Australia like Onsite that provides visibility to the whole project in one single dashboard, be it making purchase orders or handling a whole procurement process, tracking subcontractor work order against milestone completion, and sending the variation update to each member. Onsite handles it all.
The Margin Was Gone Long Before the Reconciliation
A cost overrun is not produced by the final cost reconciliation. It just shows one that has been evolving during the course of the project.
Gaps between the budget and actual cost are caused by accepted variations without price, supplies purchased at rates higher than expected, and subcontractor costs increasing more quickly than progress. These disparities are united into a single figure by reconciliation.
Contractors who safeguard their profit margins are not operating in more favorable circumstances. They recognize these problems while the project is still in progress and take action before the expenses become inevitable. This necessitates timely information flowing into the project’s financial controls from site operations, procurement, and subcontractor progress.
Every project has the information. The speed at which it is recorded, disseminated, and implemented makes a difference.
Frequently Asked Questions About Construction Cost Overruns in Australia
Research from the Grattan Institute estimates that around 65 percent of Australian infrastructure projects run over their approved budget, with a typical overrun of between nine and 20 percent after principal contracts have been awarded. KPMG survey data found that fewer than one in three Australian construction projects completed within ten percent of their original budget across a three-year study period. A government review of 82 publicly owned infrastructure projects concluded in late 2023 found approximately AUD 33 billion in overruns across a portfolio valued at AUD 120 billion. These figures are drawn from formal government project data. Overrun rates on smaller private builds are not systematically measured but are broadly considered comparable.
The three most consistent sources of margin loss are variations approved before their cost is understood, materials procured at rates above those the budget was built on, and subcontractor costs tracked against time rather than against the scope of work completed. Each of these produces a gap between the budget and actual spend that builds quietly during the project. None of them requires a dramatic event to occur. They accumulate through routine decisions — an instruction given verbally, an order placed at a new supplier rate, a subcontractor paid for days worked rather than quantities completed — that individually seem unremarkable and collectively absorb project profit.
When a variation is instructed verbally and approved in scope without a cost being agreed, the contractor carries full financial exposure for the difference between what the work actually costs and what the client accepts when the formal variation order is eventually raised. The problem compounds when variations are managed individually rather than tracked in aggregate. Twenty small variations, each appearing manageable on its own, can collectively exhaust the project contingency without any single one triggering a formal review. The straightforward fix is requiring a cost estimate before any variation work starts and tracking the running total of approved variation cost against the original contingency throughout the project.
Procurement creates hidden overruns when materials are ordered at rates that no longer match the assumptions used to build the project budget, and when no one is comparing the two in real time. Tender-stage quotes become outdated between pricing and construction. Suppliers increase rates during delivery periods. Top-up orders are placed for materials not accounted for in the original estimate. Each of these is a small deviation that looks reasonable in isolation. When purchase orders are not connected to specific budget line items, the cumulative impact on that budget category is only visible when invoices are reconciled — by which point the spending has already occurred and the options for responding have narrowed considerably.
Tracking cost against time measures how much a subcontractor has been paid relative to how long they have been working. Tracking cost against scope measures how much has been paid relative to how much of the contracted work has actually been completed. The distinction becomes important mid-project. A subcontractor two-thirds through their budget at the halfway point of their programme may appear to be tracking well on a time basis. If they are only halfway through their contracted scope, their cost-to-complete already exceeds their remaining contract value. The project manager sees the overrun at final account rather than at the mid-project point where a conversation or adjustment was still possible.
Fixed-price contracts concentrate cost risk with the contractor, making overrun prevention more critical and more difficult at the same time. The most effective protection on fixed-price work is real-time visibility into cost performance across all three risk categories: variations, procurement, and subcontractor scope. Contractors who see variation contingency consumption updating as variations are approved, who can check current committed spend against each procurement budget line at any point in the project, and who receive fortnightly scope completion records from subcontractors are in a position to identify divergence while response options still exist. Those who review cost performance monthly or at project close make decisions after the outcome is already fixed.
