BOQ vs Budget vs Actual: What Contractors Get Wrong

Why Actual Costs Rarely Tell the Full Story

What is the main difference between BOQ, budget, and actual cost

A BOQ defines the planned scope of work through measured quantities and agreed rates for each activity. Its purpose is not to estimate total project cost — that belongs to the budget. The budget converts BOQ quantities into the expected total cost of the project, incorporating labour rates, material costs, subcontractor amounts, overheads, and planned margin. Actual cost records what was genuinely spent during execution, based on verified labour attendance, material consumption, and approved invoices. All three are necessary, but they work correctly only when they connect to each other rather than being maintained in separate systems by separate teams.

Why do contractors lose control even when they have a BOQ and a budget

Because both documents are typically disconnected from daily site activity. The BOQ is assembled carefully during tendering and then referenced only at billing time. The budget is tracked against broad cost heads — civil, MEP, finishes — rather than against specific BOQ items. Site decisions about issuing material, deploying labour, and approving subcontractor work are made by teams who have no real-time view of how those decisions are moving the project against its financial baseline. By the time the impact appears in the monthly review, the site has already moved past the point where correction changes anything.

Is tracking actual cost through accounting software not sufficient

Accounting software records payments after they have been approved and processed, typically with a lag of two to four weeks behind actual site activity. That delay means the picture it presents is always backward-looking. More importantly, accounting entries do not connect to specific BOQ activities, so there is no way to identify which task caused an overrun or how the expenditure compares to the planned quantity. Without linking actual cost to execution as work proceeds, accounting reports confirm financial damage after it has occurred rather than flagging the deviation while correction is still possible.

At what stage should BOQ items be used on site

From the first day of execution, not just at tendering and billing time. When project tasks are planned against specific BOQ items rather than broad work descriptions, every progress update automatically reflects how much of the scope has been consumed. Site engineers recording a slab pour against a BOQ item are not just logging an activity — they are recording how many cubic metres were executed against the planned quantity, which immediately translates into scope percentage and budget consumption. BOQ-linked task planning is what makes daily site data financially meaningful rather than a simple record of activity.

How does linking tasks to BOQ improve budget control

When tasks are tied to specific BOQ quantities, progress updates automatically reflect how much planned scope has been consumed and how much budget that scope represents. A slab pour recorded against a BOQ item reduces the remaining quantity for that item, updates budget utilisation, and flags any variance between executed and planned quantities. This makes overruns visible at the item level rather than appearing as a large unexplained shortfall at month-end. Corrective action becomes targeted because the specific activity driving the deviation is visible at the time it occurs rather than being reconstructed after the damage has already compounded.

Why is daily tracking more effective than weekly or monthly reviews

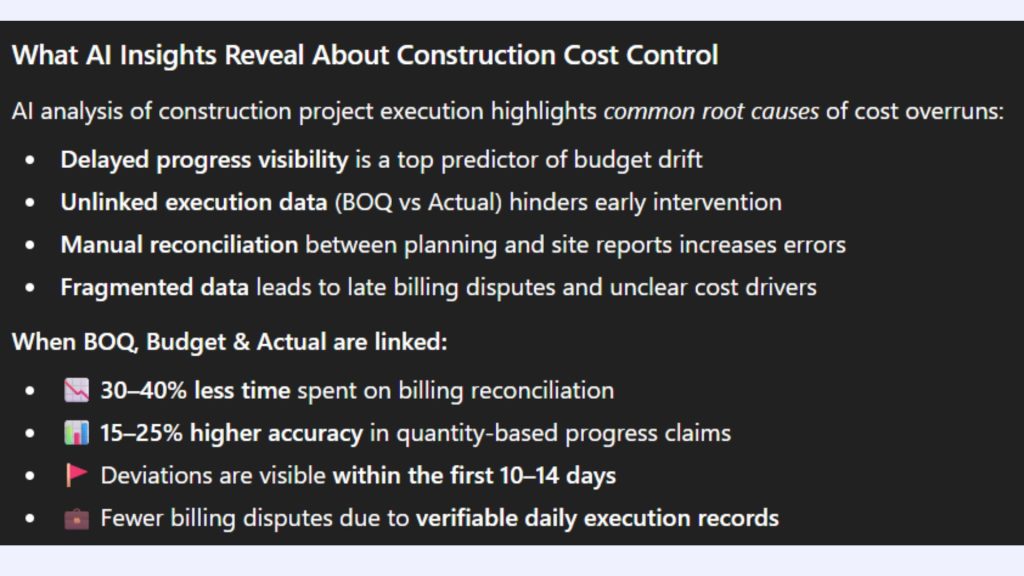

Construction problems develop continuously rather than at calendar intervals. A subcontractor underperforming on Monday creates a compounding cost and schedule problem by Friday that is difficult to recover from if it surfaces only in the following week’s review. Material consumption running five percent above the planned rate on day one becomes a meaningful budget overrun by week four if nobody flags it while work is still in progress. Daily tracking surfaces deviations close enough to the cause that corrective action — reassigning labour, revising material indents, or adjusting the work sequence — still has time to change the outcome.

How does Onsite help manage BOQ vs budget vs actual together

Onsite treats the BOQ as a live operational document rather than a static tender reference. Each BOQ item becomes the base for task creation, budget allocation, and progress tracking. Site engineers record daily activity against specific BOQ items, labour and material entries attach to those same activities, and actual costs build from verified site data in real time. The planned quantity, budgeted cost, and actual performance for every item are visible in one place throughout execution rather than reconciled at month-end. Project managers can see deviations the day they appear and respond before the impact compounds.

Can this approach help with faster billing and variations

When executed quantities are tracked against BOQ items daily, billing preparation becomes a data retrieval exercise rather than a measurement exercise. The quantities needed to raise a running account bill or variation claim are already recorded in the system with timestamps and site photographs attached, eliminating the need for a separate measurement round before each billing cycle. Variations are equally supported — when additional scope is executed beyond the original BOQ, the system holds a verified record of what was done, when, and by whom, making claims faster to prepare and easier for the client to verify and approve.

Does this replace accounting software like Tally or Zoho

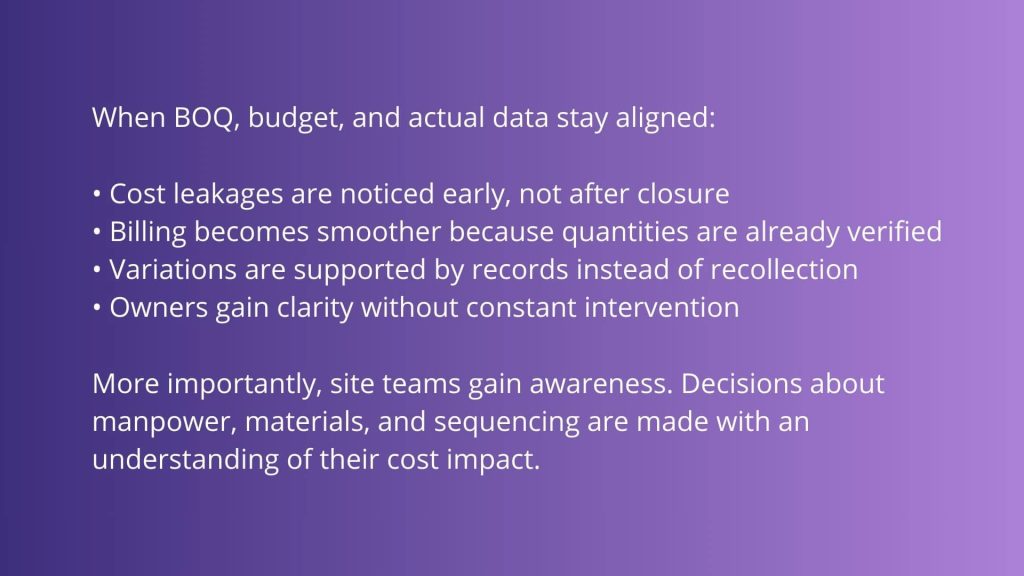

No. Accounting software handles statutory compliance, GST filings, vendor payment processing, and financial reporting for annual accounts — functions that remain essential and are served well by tools like Tally. Construction management platforms like Onsite operate in the execution layer, managing project costs, BOQ tracking, site progress, procurement, and labour attendance. The two serve different purposes and work better together than in isolation. When site-level actuals are accurate and structured at the point of entry, accounting reconciliation becomes faster because the underlying data has already been verified during execution rather than assembled during month-end close.
